Skip to main content
Project Management

The Magic of Monte Carlo: How to Stop Guessing Your Project Deadlines

Have you ever stood in a boardroom, staring at a project schedule, and felt that tiny knot of anxiety in your stomach? You have given your boss a ‘go-live’ date. Your team has given you their best estimates.

Cover image for The Magic of Monte Carlo: How to Stop Guessing Your Project Deadlines

Have you ever stood in a boardroom, staring at a project schedule, and felt that tiny knot of anxiety in your stomach? You have given your boss a ‘go-live’ date. Your team has given you their best estimates. But deep down, you know that a single flat tire, a delayed vendor, or a sick lead developer could send the whole deck of cards tumbling down.

We have all been there. Project management often feels like trying to predict the weather in a world where it might rain frogs at any moment. Traditional scheduling asks us to pick a single number-a ‘best guess’-and bet our professional reputation on it. But what if I told you there’s a better way? What if you could look at a project not as a single date on a calendar, but as a map of possibilities?

This is where Monte Carlo simulation comes in. It sounds like a high-stakes gambling strategy (and yes, it is named after the famous casino), but for project managers, it is the ultimate ‘BS detector.’ It is a mathematical tool that runs thousands of ‘what-if’ scenarios in seconds. It shows you the risks you can’t see and helps you commit to deadlines you can actually hit. Today, we are going to pull back the curtain on this ‘scary’ math and show you how to use it to become the most confident person in the room.

Why ‘One Number’ is a Dangerous Lie

In the world of project management, we are often forced to live in a ‘Point Estimate’ world. Your stakeholder asks, ‘How long will the design phase take?’ and you answer, ’22 days.’

But 22 days isn’t a fact. It’s an average. It’s what happens if things go ‘mostly okay.’

When we only use one number, we ignore the uncertainty of life. We ignore the fact that the design could take 10 days if the client loves the first draft, or 45 days if they decide to change the entire brand identity halfway through. By ignoring those extremes, we set ourselves up for failure.

Monte Carlo simulation changes the conversation. Instead of saying, ‘It will take 22 days,’ you get to say, ‘There is a 90% chance we finish within 38 days.’ Do you see the difference? The second statement is honest. It accounts for risk. It gives you a buffer based on math, not just a ‘gut feeling.’

The Math: Meet the Triangular Distribution

To run a Monte Carlo simulation, we need to give the computer some rules. We can’t just tell it to ‘guess.’ We use something called a Triangular Distribution.

Don’t let the name intimidate you. If you can imagine a triangle, you already understand the math. For every task in your project, we ask for three specific numbers:

  1. Optimistic (A): The ‘everything goes perfectly’ scenario.
  2. Most Likely (M): The ‘this is what usually happens’ scenario.
  3. Pessimistic (B): The ‘everything goes wrong’ scenario.

When you put these three points on a graph, they form a triangle. The highest point of the triangle is your ‘Most Likely’ (M) value, because that’s where the most ‘probability’ lives.

How the Computer ‘Rolls the Dice’

Imagine you have a giant jar of 10,000 marbles. Each marble has a number written on it representing a possible duration for your task. Because we used a triangular shape, the jar has a lot of marbles labeled ’22’ (your Most Likely) and very few marbles labeled ’10’ (your Optimistic) or ’45’ (your Pessimistic).

When we run a Monte Carlo simulation, the computer reaches into that jar, pulls out a marble, records the number, and throws it back. It does this 10,000 times.

The Grade 12 Math Behind the ‘Marble’

If you were in a high school stats class, your teacher would explain that the computer uses something called Inverse Transform Sampling.

Here is the simple version: The computer generates a random number between 0 and 1 (let’s call it ‘u’). This ‘u’ represents a percentage. If ‘u’ is 0.50, the computer looks for the value that sits exactly at the 50% mark of your triangle’s area.

Because the area of a triangle involves squaring its sides (remember: Triangle Area = 1/2 * base * height), the computer has to use a Square Root to find the exact day.

If the random number is on the ‘left’ side of the peak, the math looks like this:

If the random number is on the ‘right’ side of the peak, it uses a slightly different version to pull from the ‘pessimistic’ slope. By doing this thousands of times, the computer creates a ‘pile’ of data that perfectly matches the shape of your triangle.

From One Task to a Whole Project

The real magic happens when you have a project with multiple tasks. Let’s say you have three tasks: Design, Development, and Testing.

In a traditional spreadsheet, you would just add the averages:

22 + 15 + 12 = 49 days

But in a Monte Carlo simulation, the computer creates 10,000 ‘Possible Futures’ for the entire project.

In Future #1, Design is fast, but Development is late, and Testing is on time.

In Future #2, everything goes wrong and all three tasks are late.

In Future #3, everything goes perfectly and you finish in record time.

The computer adds the results of all three tasks together for each of these 10,000 futures. Suddenly, you aren’t looking at a single triangle anymore. You are looking at a Distribution of Totals.

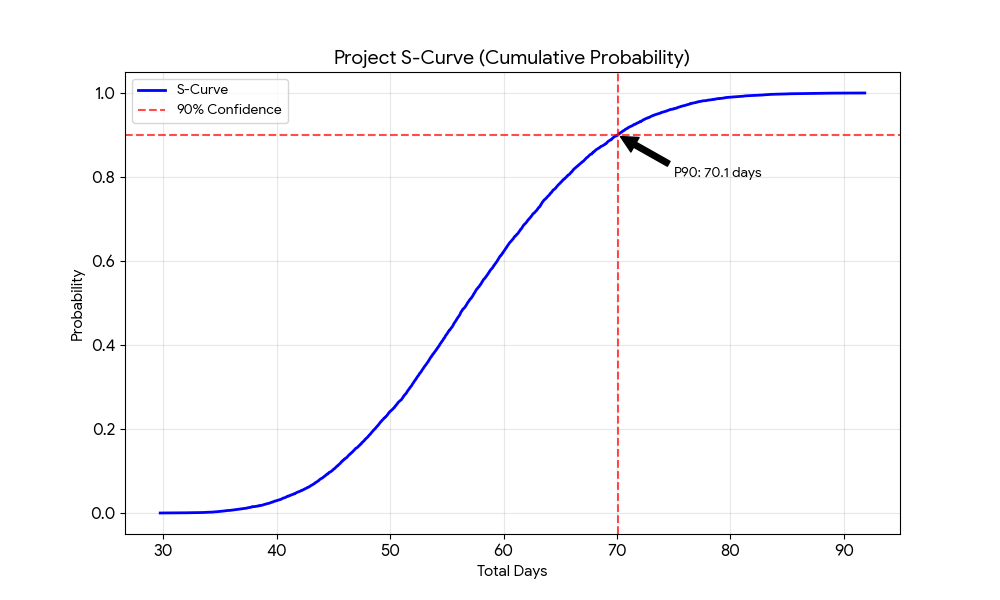

How to Read the Results: The ‘S-Curve’

Once the simulation is done, you’ll have a list of 10,000 project durations. To make sense of them, we sort them from shortest to longest. This creates what we call an S-Curve (or a Cumulative Probability plot).

This is the most important chart you will ever use as a project manager.

The x-axis shows the total days for the project. The y-axis shows the probability (from 0% to 100%).

The P-Values: Your New Best Friends

When you look at your sorted list of results, you can find specific ‘P-values’ (Percentiles):

  • P10 (The Optimistic Target): Find the 1,000th result in your list. There is only a 10% chance you’ll finish earlier than this. This is your ‘Aggressive’ deadline.
  • P50 (The Coin Flip): Find the 5,000th result. This is the median. You have a 50/50 chance of hitting this.
  • P90 (The Safe Zone): Find the 9,000th result. This is the ‘Safe’ deadline. 90% of your simulated futures finished by this date.

What This Means for Your Day-to-Day Work

You might be thinking, ‘This sounds like a lot of work for a few charts.’ But the impact on your daily life as a project manager is massive. Here is how it changes the game:

1. No More ‘Padding’ Guilt

We all ‘pad’ our estimates. We add a few days here and there because we’re afraid of being late. But when we pad every single task, the project looks twice as long as it needs to be, and stakeholders get frustrated.

Monte Carlo allows you to be aggressive with individual task estimates because the math provides the buffer at the project level. You don’t need to hide extra days in ‘Design’; the simulation tells you exactly how much contingency you need for the whole project.

2. Managing Stakeholder Expectations

When your boss asks, ‘Why can’t we finish in 50 days?’ you don’t have to just say, ‘Because it’s hard.’

You can pull up your S-Curve and say, ‘According to our simulation, we only have a 15% chance of finishing in 50 days. However, if we move the date to 62 days, our confidence jumps to 90%.’

It turns a high-pressure argument into a logical discussion about risk tolerance. Does the company want to gamble on a 15% chance, or do they want a plan they can rely on?

3. Identifying the Real ‘Risk Drivers’

If you run a simulation and your P90 is way too late, you can look at your three tasks and see which one has the ‘fattest’ triangle. If Task 2 has a Pessimistic estimate that is miles away from its Most Likely estimate, that is your primary risk. You now know exactly where to focus your management energy to bring the project back under control.

The ‘Portfolio Effect’: Why You’re Safer Than You Think

One of the most surprising things you’ll learn from Monte Carlo is that you don’t need to prepare for the ‘Absolute Worst Case’ for every task.

If you added up the Pessimistic (B) values for three tasks ($45 + 30 + 25$), you’d get 100 days. But the simulation will show you that the P90 might only be 75 days.

Why? Because it is statistically almost impossible for every single task to hit the absolute worst-case scenario at the same time. While one task is dragging behind, another will likely be ahead of schedule. They balance each other out. This is called the Portfolio Effect, and it’s why Monte Carlo gives you much more realistic (and often shorter) project durations than ‘adding up the worst-case scenarios’ ever could.

Practical Tips for Your First Simulation

Ready to try this out? You don’t need a PhD in statistics. You can run these simulations in Python or even in specialized Excel plugins. Here are some tips to keep your model accurate:

  • Be Honest with ‘B’: Don’t be afraid of the Pessimistic estimate. If a task could truly take 60 days if the server melts down, put 60. The math will handle the rest.
  • Don’t Over-complicate: Start with your top 5-10 major milestones. You don’t need a triangle for every single 2-hour task.
  • Update Regularly: As tasks finish, replace their ‘triangles’ with the actual number of days they took. Re-run the simulation to see how your P90 date shifts.
  • Visualize the S-Curve: Always show the S-Curve to your team. It helps them understand that a ‘deadline’ isn’t a point-it’s a probability.

Summary: From Guessing to Knowing

Monte Carlo simulation might seem like ‘extra work,’ but it is actually a time-saver. It saves you from the hours of stress that come from defending a deadline you knew was impossible. It saves you from the ‘blame game’ when a project runs late.

By using the Triangular Distribution and a few thousand ‘rolls of the dice,’ you transform your project schedule from a static list of dates into a living, breathing risk model. You move from ‘I hope we finish’ to ‘I am 90% confident we will finish.’

And in the high-stakes world of project management, that confidence is worth its weight in gold.

Try It Yourself: Run Your Own Simulation

If you are feeling brave or if you already know a bit of Python, you do not have to take my word for it. You can see the magic of Monte Carlo with your own eyes.

You do not need to install any complex software on your computer. Simply open a free tool like Google Colab or any Jupyter Notebook, and paste the code block below.

This script is a “ready-to-run” version of everything we have discussed. It will simulate a single task (Design) and then a full project with three tasks (Design, Development, and Testing). It calculates the mathematical means, the P90 safety buffers, and generates the exact S-Curve and histograms you need to see the risk.

Go ahead—change the numbers for A, M, and B in the code and see how the P90 shifts. It is the best way to develop a “gut feel” for project risk.


import random
import matplotlib.pyplot as plt

# --- 1. SETTINGS & DATA ---
iterations = 10000

# Task Format: [Optimistic (A), Most Likely (M), Pessimistic (B)]
task_1 = [10, 22, 45]  # e.g., Design
task_2 = [5, 15, 30]   # e.g., Development
task_3 = [8, 12, 25]   # e.g., Testing

all_tasks = [task_1, task_2, task_3]

# --- 2. THE SIMULATION ENGINE ---
def get_triangular_sample(estimates):
    """
    Implements Inverse Transform Sampling for a Triangular Distribution.
    """
    a, m, b = estimates
    u = random.random()
    fc = (m - a) / (b - a)

    if u < fc:
        # Left side of the triangle
        return a + (u * (b - a) * (m - a))**0.5
    else:
        # Right side of the triangle
        return b - ((1 - u) * (b - a) * (b - m))**0.5

# --- 3. RUNNING THE MONTE CARLO ---
single_task_results = []
project_total_results = []

for _ in range(iterations):
    # Part A: Simulate just Task 1
    t1_val = get_triangular_sample(task_1)
    single_task_results.append(t1_val)

    # Part B: Simulate the whole project (Sum of 3 tasks)
    t2_val = get_triangular_sample(task_2)
    t3_val = get_triangular_sample(task_3)
    project_total_results.append(t1_val + t2_val + t3_val)

# Sort results to calculate percentiles (P10, P50, P90)
single_task_results.sort()
project_total_results.sort()

# --- 4. ANALYSIS & STATS ---
def calculate_stats(data):
    return {
        'mean': sum(data) / len(data),
        'p90': data[int(len(data) * 0.90)]
    }

stats_single = calculate_stats(single_task_results)
stats_project = calculate_stats(project_total_results)

# --- 5. VISUALIZATION ---
plt.figure(figsize=(18, 6))

# Plot A: Single Task Distribution
plt.subplot(1, 3, 1)
plt.hist(single_task_results, bins=50, color='skyblue', edgecolor='black', alpha=0.7)
plt.axvline(stats_single['mean'], color='red', linestyle='--', label=f"Mean: {stats_single['mean']:.1f}d")
plt.axvline(stats_single['p90'], color='darkred', linestyle='-', label=f"P90: {stats_single['p90']:.1f}d")
plt.title('Single Task (Design) Distribution')
plt.xlabel('Days')
plt.ylabel('Frequency')
plt.legend()

# Plot B: Project Totals Distribution
plt.subplot(1, 3, 2)
plt.hist(project_total_results, bins=50, color='lightgreen', edgecolor='black', alpha=0.7)
plt.axvline(stats_project['mean'], color='red', linestyle='--', label=f"Mean: {stats_project['mean']:.1f}d")
plt.axvline(stats_project['p90'], color='darkred', linestyle='-', label=f"P90: {stats_project['p90']:.1f}d")
plt.title('Total Project Distribution (3 Tasks)')
plt.xlabel('Total Days')
plt.ylabel('Frequency')
plt.legend()

# Plot C: The S-Curve (Cumulative Probability)
plt.subplot(1, 3, 3)
probs = [i / iterations for i in range(iterations)]
plt.plot(project_total_results, probs, color='darkblue', linewidth=2, label='Project S-Curve')

# Vertical and Horizontal Intercepts for P90
plt.axhline(0.90, color='red', linestyle=':', alpha=0.8, label='90% Confidence')
plt.axvline(stats_project['p90'], color='red', linestyle=':', alpha=0.8)

# Adding Text Label for the Intersection
plt.text(stats_project['p90'] + 1, 0.85, f"P90 = {stats_project['p90']:.1f} Days", color='red', fontweight='bold')

plt.title('Project S-Curve (Risk Analysis)')
plt.xlabel('Total Project Days')
plt.ylabel('Probability (0 to 1.0)')
plt.grid(alpha=0.3)
plt.legend(loc='lower right')

plt.tight_layout()
plt.show()
